Understanding the financial structure of construction projects is essential for architects. Whether you’re managing a client’s budget expectations,, leading your first project, or preparing for the ARE, knowing the difference between hard costs vs soft costs is crucial.
Most budget overruns and client disappointments stem from confusion about these cost categories and their implications. So what exactly separates these costs, and why should you know the difference? This guide breaks down everything you need to know about hard costs vs soft costs – the financial backbone of every construction project.
This podcast is also available on YouTube, Spotify, and Apple Podcasts

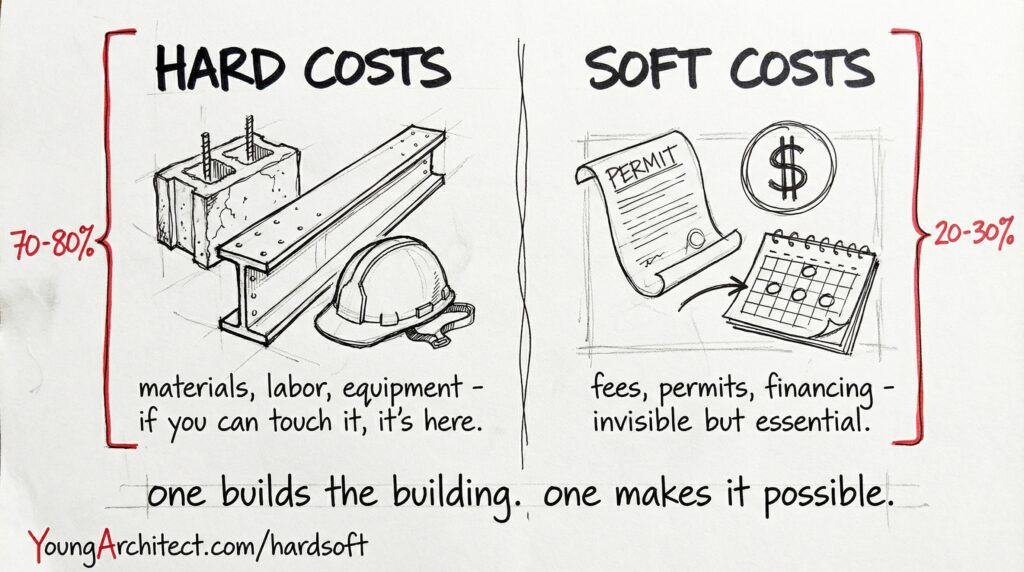

Defining Hard Costs and Soft Costs
What are hard costs? Hard costs are the tangible, physical expenses that directly create the actual physical building. This includes the building’s materials like concrete, steel, lumber, labor, equipment rental, and all physical items used in construction. Simply put: if you can touch it or see it in the finished building, it’s a hard cost. Examples include:
- The concrete in your foundation
- The steel beams supporting your structure
- The hourly wages paid to construction workers
- The HVAC equipment and ductwork
- The flooring materials and paint
What are soft costs in construction? Soft costs are the intangible, indirect expenses that don’t become part of the physical building but are necessary management and administrative layers of a project to make that project happen. These costs occur before, during, and after construction. Examples include:
- Architectural and engineering fees
- Building permits and inspection fees
- Construction loan interest
- Insurance premiums
- Project management fees
- Legal and accounting services
Think of it this way: hard costs build the actual structure; soft costs make it legal, possible, and done right.
Key differences between hard cost vs soft cost in construction include:
- Tangibility: Hard costs are physical materials and labor; soft costs are services and fees
- Predictability: Hard costs are generally easier to estimate (we can count how many bricks we need); soft costs can be more variable (how long will city permitting take?)
- Timing: Hard costs occur primarily during construction; soft costs span the entire project lifecycle
- Visibility: Clients can see hard costs in action; soft costs are often “invisible” expenses
Both types are absolutely essential. You can’t build a project with only hard costs – who would design it? How would you get permits? And you certainly can’t build it with only soft costs – architectural drawings alone don’t keep the rain out of your building! Understanding hard costs vs soft costs before a project even begins is critical for accurate budgeting and successful outcome.
Common Examples of Hard and Soft Costs

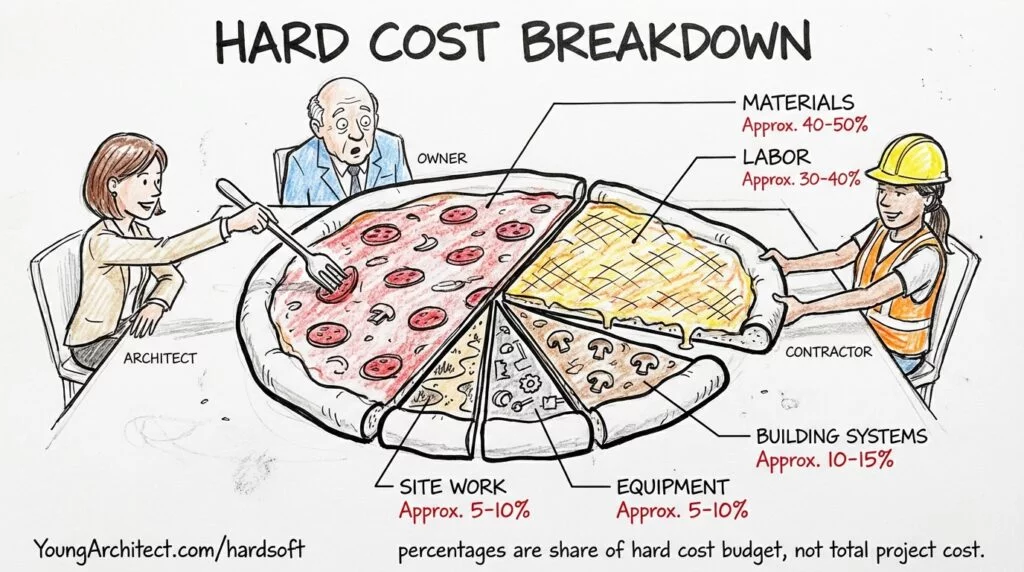

Hard Costs Include:
Construction materials – typically 40-50% of hard costs:
- Foundation and structural elements (concrete, steel, wood framing)
- Exterior envelope (cladding, roofing, windows, doors)
- Interior finishes (drywall, flooring, ceiling systems, paint)
- Material shipping and delivery costs
Labor – usually 30-40% of hard costs:
- General labor costs
- Skilled trades (electricians, plumbers, HVAC specialists)
- Wages, benefits, overtime considerations
- Labor burden costs
Equipment and temporary facilities – about 5-10% of hard costs:
- Heavy machinery (bulldozers, cranes, excavators)
- Scaffolding, formwork, temporary power
- Tools and specialized equipment
- Equipment maintenance and fuel
Site work:
- Excavation and grading
- Utilities and connections
- Landscaping and hardscaping
Building systems:
- HVAC systems and controls
- Electrical infrastructure
- Plumbing and fire protection
- Technology and security systems
Remember, if your client wants to “save money” by cutting hard costs, they’re literally taking pieces out of their building!
Soft Costs Include:
Design and engineering fees – usually 8-15% of total project costs:
- Architectural services (schematic design through construction administration)
- Engineering disciplines (structural, MEP, civil)
- Specialty consultants (acoustics, lighting, sustainability)
Permits and regulatory fees – can be 3-5% of project costs in some jurisdictions:
- Building permits
- Impact and connection fees
- Zoning and environmental approvals
- Inspection costs
Legal and accounting services:
- Contract preparation and review
- Land acquisition work
- Tax planning and reporting
Financing costs – often overlooked but substantial on longer projects:
- Construction loan interest (can add up significantly over time!)
- Loan origination fees and points
- Appraisal and financial due diligence fees
Construction loan interest is the stealthy ninja of soft costs—silent but deadly to your budget. While everyone’s focused on the drama of steel prices, interest is quietly emptying your wallet in the background.
Insurance and bonds:
- Builder’s risk insurance
- Professional liability insurance for architects and risk management
- Performance and payment bonds that protect construction projects
Project management:
- Owner’s representative fees
- Construction management services
- Administrative and coordination costs
Marketing and leasing (for commercial projects):
- Marketing materials and campaigns
- Broker commissions
- Lease-up costs
Many clients don’t realize how substantial these soft costs can be. They focus on the construction contract (hard costs) and sometimes get blindsided by the cumulative impact of all these “invisible” expenses. It’s our job to help them see the full picture!
Typical Ratios and Project Types
The common rule of thumb is that hard costs usually account for about 70-80% of the total project budget, with soft costs making up the remaining 20-30%. But that’s just a starting point – the actual ratio varies significantly depending on the project type.
Residential projects often have lower soft cost percentages, typically around 10-20%:
- Single-family homes have simpler designs and shorter timeframes
- They face less complex regulatory requirements
- They generally involve smaller teams
But beware – custom homes with complex designs and high-end finishes might have higher architect fees and permit costs, pushing that soft cost percentage up. That Frank Lloyd Wright-inspired masterpiece isn’t going to design itself!
Commercial projects and institutional clients typically see soft costs around 20-30%:
- Office buildings and retail centers have more complex regulatory requirements
- They face higher financing costs due to larger loans and longer durations
- Don’t forget all those marketing and leasing expenses that add up quickly
Institutional projects like hospitals, schools, and government buildings can reach 25-35% in soft costs:
- These projects often require complex designs with specialized consultants
- They involve multiple stakeholders and approval processes
- They face stricter regulatory requirements
- They need more extensive commissioning and documentation
By the time you’ve finished navigating the approval committees, stakeholder reviews, and regulatory agencies for a hospital project, you could have designed and built three houses, written a novel, and learned to play the banjo.
These costs interact with project timelines in interesting ways:
Soft costs are heavily front-loaded – they start piling up long before construction:
- Design and engineering work happens months before breaking ground
- Permits and approvals must be secured up front
- Financing arrangements begin early
But they don’t stop there! Soft costs continue throughout the project:
- Loan interest accrues every month
- Insurance premiums continue
- Project management expenses are ongoing

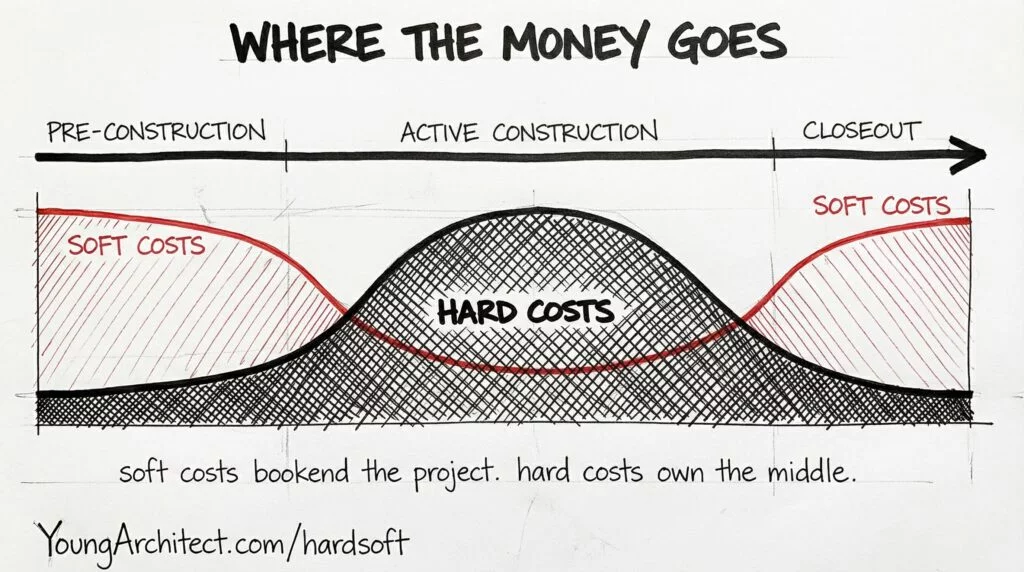

Meanwhile, hard costs follow what we call the S-curve model:
- Low spending at the beginning during site prep and foundations
- Peak spending during the main construction phase
- Tapering off during finishing work
Time-dependent soft costs increase substantially with delays. Every month of delay means another month of loan interest, extended insurance coverage, and continued project management fees. The meter keeps running even when the workers don’t!
A construction delay is the only thing that can make architects, contractors, and owners all equally miserable at the same time. It’s like a team-building exercise nobody asked for.
Managing Hard and Soft Costs Effectively
Different project stakeholders view and interact with these costs differently:
From the Architect’s Perspective:
- Our fees are a soft cost to the project, but our design decisions directly impact hard costs
- We must balance design quality with budget constraints
- We’re responsible for helping the owner establish realistic budgets from the beginning
- When we make design changes, we need to understand how they affect both cost types
Value engineering often starts with good intentions but ends with phrases like, “Do we really need fire sprinklers on the upper floors? People can just run downstairs, right?” No, Bob. Just… no.
From the Contractor’s Perspective:
- Contractors primarily manage hard costs directly
- They submit bids based on detailed material and labor estimates
- They focus intensely on construction efficiency and productivity
- They coordinate with us on design issues that affect costs
From the Owner’s Perspective:
- Owners bear responsibility for the entire project budget
- They must secure financing to cover all costs
- They’re often most concerned about potential cost overruns
- Many owners, especially first-timers, don’t fully appreciate the magnitude of soft costs until they’re deep into a project
Many first-time clients think construction is like ordering from Amazon—just click what you want, and it shows up at your door. Then they meet their first building inspector and realize it’s more like negotiating with a DMV employee who’s also a part-time building code philosopher.
Here are some proven approaches for managing both cost types:
Thorough early planning and accurate estimating:
- Create detailed cost breakdowns by category
- Use historical data and industry benchmarks
- Get expert input on soft cost estimates before setting budgets
Realistic contingency planning for construction projects:
- Set aside 5-10% for new construction hard costs
- Budget 10-20% for renovation hard costs
- Consider separate contingencies for hard and soft costs
The word “contingency” comes from the Latin word for “the money you’ll definitely need but didn’t think you would.” OK, that’s not true, but it should be!
Clear communication between all parties:
- Hold regular budget review meetings
- Develop comprehensive cost reports that show both hard and soft expenses
- Create a transparent construction change order process that addresses all cost impacts
Regular quality assurance and quality control monitoring systems:
- Track expenditures against budget in real-time
- Forecast final costs based on current data
- Take corrective action early when issues arise
I once had a client who wanted to “save money” by cutting our construction administration services – a soft cost. Six months later, when the contractor installed the wrong windows because no one was reviewing submittals, the resulting hard costs for replacement far exceeded what our CA services would have cost!
Why This Matters
For those studying for the ARE, this knowledge is directly applicable to all six exam divisions. Hard costs vs soft costs can appear across the entire ARE:
Practice Management (PcM) questions frequently address budget concepts, fee structures, and financial management principles.
Project Management (PjM) tests your knowledge of project budgets, cost control, and resource allocation.
Programming & Analysis (PA) includes cost estimation during early project phases and budget establishment.
Project Planning & Design (PPD) covers cost implications of design decisions and value engineering approaches.
Project Development & Documentation (PDD) includes constructability and cost considerations in detailing.
Construction & Evaluation (CE) involves cost control during construction and change order management.
In real-world practice, you’ll use this understanding for:
Client budget discussions and expectations management:
- Explaining early in the process what soft costs to anticipate
- Setting realistic expectations about the full project budget
- Discussing how design decisions impact costs
Contract negotiations and fee proposals:
- Understanding your services’ value relative to overall project costs
- Properly accounting for cost management in fee structures
- Establishing clear scope boundaries
Project budget development and monitoring:
- Creating structured cost breakdown templates
- Implementing milestone reviews for budget validation
- Tracking expenses effectively across categories
Understanding both hard and soft costs won’t win you any design awards, but it might just help you stay in business long enough to win those awards later! As architects, we may be hired for our design vision, but we’re valued for our ability to turn that vision into reality within budget constraints.
The Bottom Line on Construction Costs
Hard costs vs soft costs are two sides of the same coin – both essential to creating successful projects. Hard costs create the physical building, while soft costs enable the planning, approvals, and management.
The key takeaways:
- Hard costs are tangible and visible in the finished product – typically 70-80% of your budget
- Soft costs are intangible but absolutely necessary – typically 20-30% of your budget
- The ratio between hard cost vs soft cost varies by project type
- Early planning and clear communication are essential for managing both
- Understanding what are hard costs and what are soft costs is crucial for both exam success and professional practice
Ready to deepen your understanding of construction economics? The ARE 101 course membership at The Young Architect Academy covers these financial concepts in much greater detail, with hundreds of practice questions designed to help ARE candidates master these topics. The Young Architect Academy offers comprehensive study materials that break down complex concepts like hard costs vs soft costs into exam-ready content.
For a deeper dive into related topics, check out our articles on Construction Contingency and Construction Bonds Explained.
Remember: understanding costs doesn’t make you less creative – it makes your creative visions possible!
